BIERTON TRAFFIC CALMING INFORMATION

A418 Aylesbury Road

Thank you for visiting this website.

P&S Plant and Construction Ltd has been contracted to undertake essential traffic calming works along the A418, from Mike Griffin Way down to the double mini roundabouts.

PROJECT SCHEDULE AND SCOPE

  • NOTICEBOARD:
    • Works have been progressing in line with the phase 1 programme to deliver the traffic calming features.
    • New build outs have been constructed which may increase congestion until traffic gets accustomed to the new layout.
    • Some of the traffic calming features cannot be constructed until a temporary road closure in the Easter holidays 2025.
    • In the interim, temporary bollards and signage will be utilised to replicate the permanent features.
    • Please be mindful that we may see an increase in congestion through the village as users become familiar with the new layout.
    • It is encouraged that users utilise Mike Griffin Way and Bellingham Way to avoid Bierton Village.
    • Completion of the permanent installations (Phase 2) will be constructed during a temporary road closure during the Easter holidays 2025.

Whilst every effort will be made to stick to our programme we cannot always guarantee these exact dates will be met. Experience has shown that no matter how much preparation is conducted there will always be the potential for unforeseen challenges in relation to weather and in the ground once the works begin. In such circumstances we will of course do our utmost to get back onto programme and we will conduct regular updates to this web page to ensure that you are fully informed of the current dates.

LATEST PLANS - DOWNLOADABLE PDF

  • The updated General Arrangement drawings capture minor changes that include adjustments to the positioning of traffic calming features outside St James the Great Church and the substitution of imprint paving with coloured surface finishing.
  • Please note these plans are subject to minor changes if deemed necessary.

GENERAL ARRANGEMENT LAYOUTS

1 OF 11

  • Proposed gateway feature on the left hand side is temporary and it will be built on phase 2 in 2025. On the right side there is a new buildout which was completed last week.
  • Proposed build out feature on the left hand side is completed. On the right is going to be temporary and it will be built on phase 2 as it shows on drawing number 1

2 OF 11

  • Bus stop opposite house number 71 done completed.
  • Proposed crossing point feature footpath has been completed

3 OF 11

  • Crossing point feature has been completed, the remainder of this sheet will be completed on 07-10-24.

4 OF 11

  • Proposed traffic island features all complete.
  • Proposed heritage coloured feature to be completed next year. Outside house 125 Morrison the proposed water division will be working on 12-10-24

5 OF 11

  • Proposed chicane feature -7 on the left-hand side as permanent to be completed by 10-10-24.

6 OF 11

  • Proposed raised table feature -8 to be completed in 2025
  • Proposed build outs feature -9 on the left to be completed on 14-10-24 on the right is temporary to be build on phase 2

7 OF 11

  • Proposed heritage coloured feature -10 and 11 to be built in 2025.

8 OF 11

  • Bus stop to be readjusted and completed by 29-10-24

9 OF 11

  • Bus stop to be readjusted and completed by 29-10-24
  • Proposed crossing point feature -12 footpath and tactile paving to be finished by 29-10-24 on phase 1 middle section will be don on phase 2

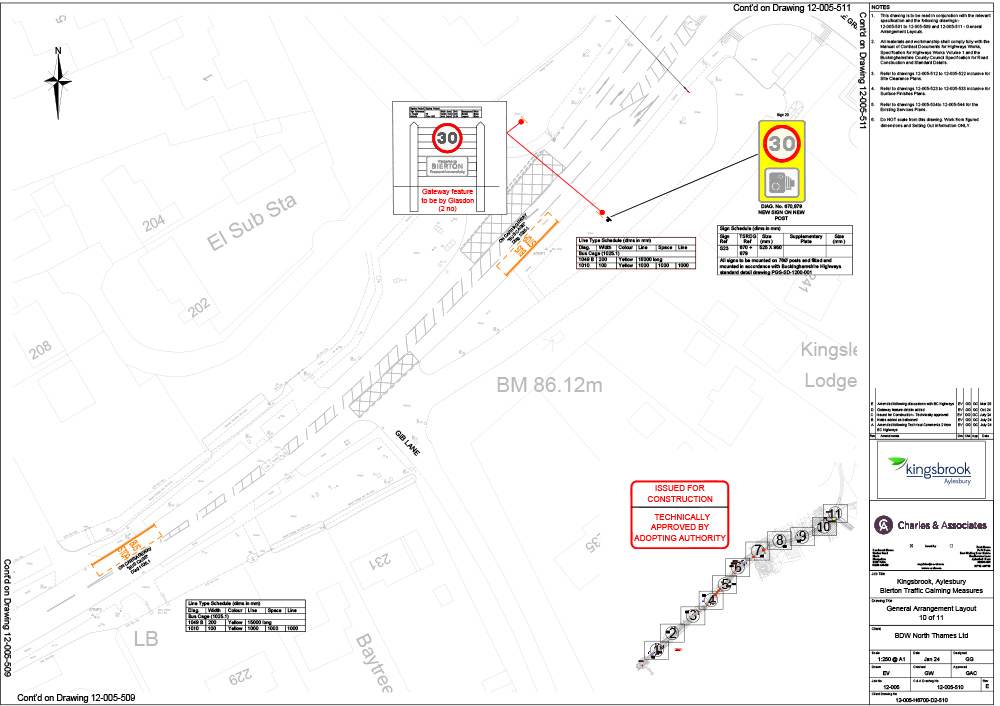

10 OF 11

  • To be completed by 29-10-24

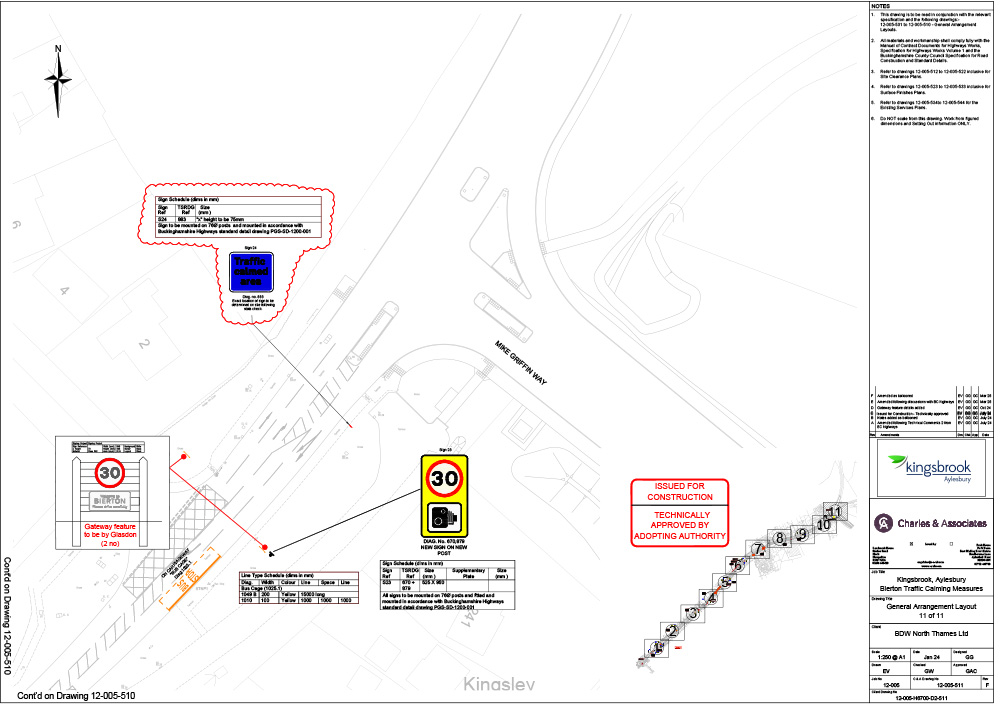

11 OF 11

  • To be completed by 29-10-24

All works this year aiming to be completed by end of October with Phase 2 in 2025.

Please address any concerns or questions you may have throughout the duration of the project to P&S Plant and Construction;

email: [email protected]
phone: 07413 767175

Thank you for your patience and support as we undertake these important improvements.
